North Parkway Construction, News, and Impacts

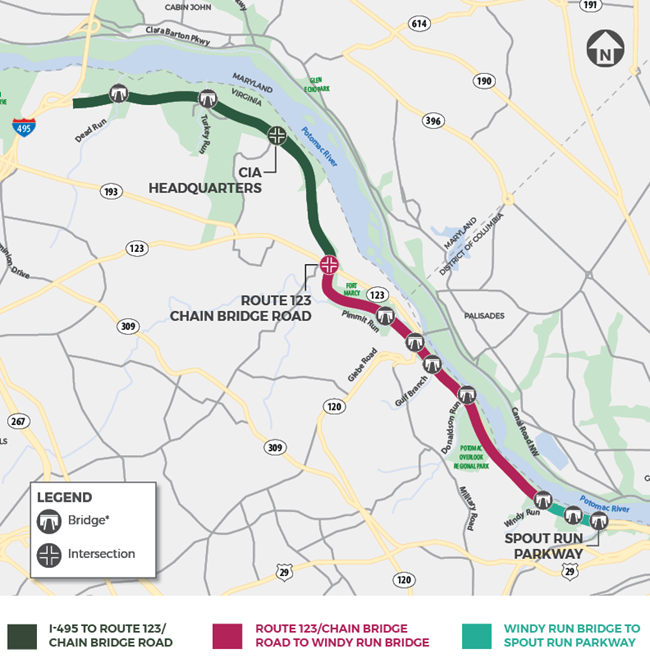

This infographic displays the project rehabilitation area
This infographic displays the project rehabilitation area

NPS

The National Park Service (NPS) has reached substantial completion of the north parkway rehabilitation project on the George Washington Memorial Parkway. The project, which began construction in 2022, improves safety and resilience through rehabilitated pavement and drainage, strengthened roadside features and restored historic overlooks. Some finishing work will continue into spring 2026 during off-peak travel hours. Motorists can expect travel impacts once crews begin rehabilitation efforts on the Route 123 Interchange bridge.
View construction updates under Current Construction.

  • To opt in to receive email updates about traffic impacts and other news please click here.
  • To contact the project team please  e-mail us.  
  • View recordings of informational public meetings on our public meeting webpage.

Rehabilitation Completion Along the Parkway

As of early January, crews have reached the following milestones:

  • 98% of the guardwall has been repaired or replaced, upgrading motorist safety.
  • 98% of the bridge repairs are complete, rehabilitating aging infrastructure.
  • 100% of the roadway has been replaced, improving drivability and safety. 
  • 100% of the drainage work is complete, reducing erosion and sediment run off.
  • 100% of the outfalls have been repaired, completing work to improve drainage structures that discharge water to nearby streams.
The NPS thanks you for your patience over the last three years as we worked to rehabilitate 7.6 miles of the parkway, improving the driving experience and safety for motorists, while maintaining the culture of this historic landmark near our nation’s capital. See below for current construction details and impacts in each segment.

Current Construction (Updated February 2026)

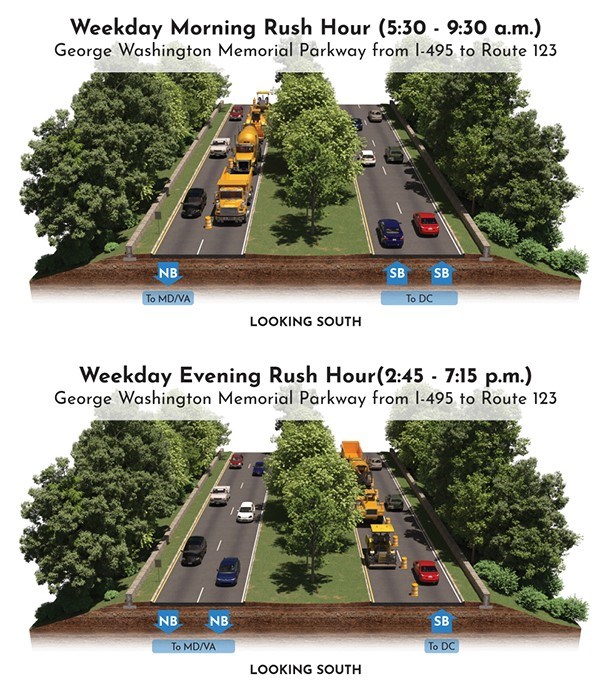

I-495 to Route 123

Crews continue curb work at the I-495 Interchange. Motorists can expect finishing work during off-peak travel hours for median restoration activities.

Route 123 to Spout Run Parkway

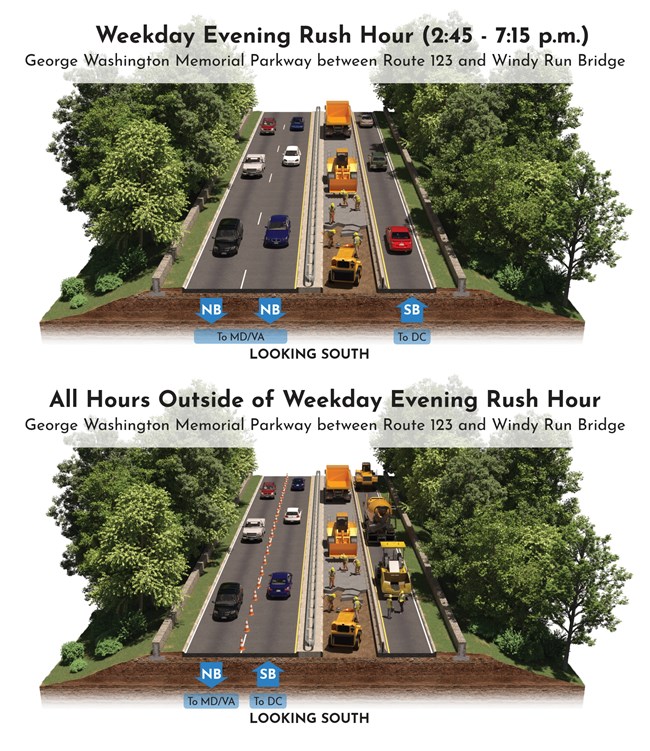

Repairs on the concrete median and guardrail continue. Motorists can expect finishing work during off-peak travel hours for median restoration activities.

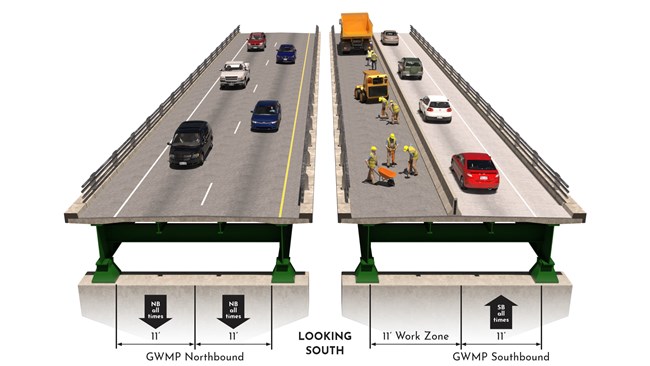

Bridge Construction

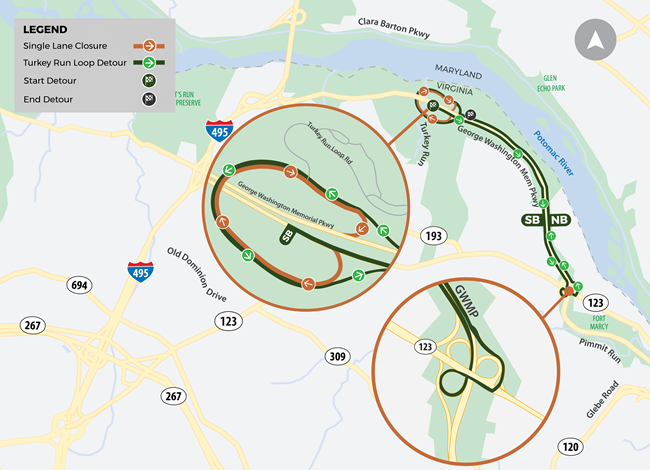

Crews have completed repairs on and below the bridge surface at Glebe Road, Pimmit Run, Dead Run, Turkey Run, and Spout Run Northbound and Southbound Arch bridges, rehabilitating aging infrastructure.

Finishing work continues on concrete median installations at bridge approaches, in addition to median repairs at Gulf Branch and Windy Run bridges in early 2026. No additional traffic delays are anticipated at this time.

All work is weather permitting. In the event of inclement weather, work will be rescheduled. Any changes in the closure schedule above will be reflected on this page.

Construction Zone Safety

Please slow down and be cautious while driving through work zones on the parkway. Commercial vehicles are restricted from the parkway at all times. Signage will direct drivers to the appropriate lanes.

  • Drivers should observe traffic signs for updated information.
  • A 40 MPH speed limit remains in effect from the I-495 interchange to Spout Run Parkway to help keep construction crew and motorists safe. This speed limit will be in place for the remainder of the project and is enforced as such.
  • To avoid traffic delays on the northern section of the parkway, drivers should consider alternate routes and plan for additional travel time.
  • Remember vehicles over 10,000 lbs. are always prohibited from using the parkway.

Additional Rehabilitation Work on the George Washington Memorial Parkway
The NPS has identified additional rehabilitation work on the George Washington Memorial Parkway. This work is anticipated to begin in 2026, taking advantage of the current construction workforce to facilitate this additional work and reduce traffic impacts.

  • Route 123 Interchange Bridge Work and Traffic Impacts 
    The Route 123 Interchange Bridge is in need of additional repairs to rehabilitate aging infrastructure. The NPS anticipates that there will be a single travel lane closed. The exit rampto Route 123 eastbound and westbound will have a reduced deceleration lane. Lanes adjacent to the exit ramps will also be closed during rush hour.

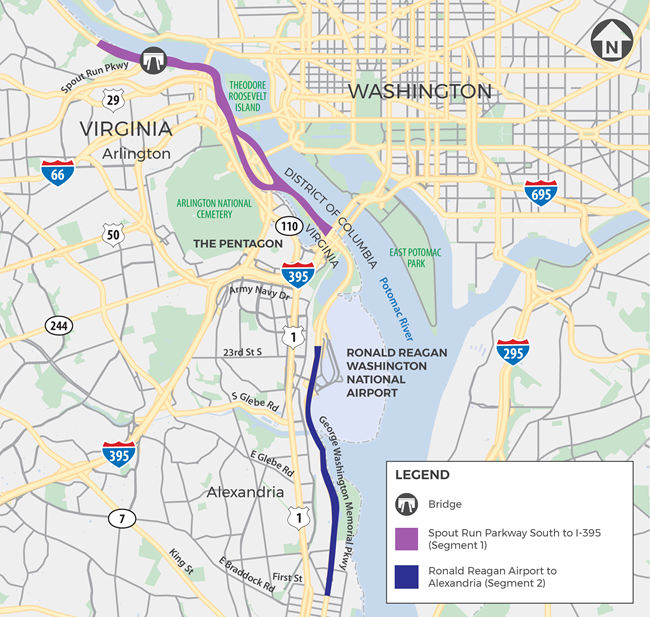

  • Additional Mill and Overlay Work

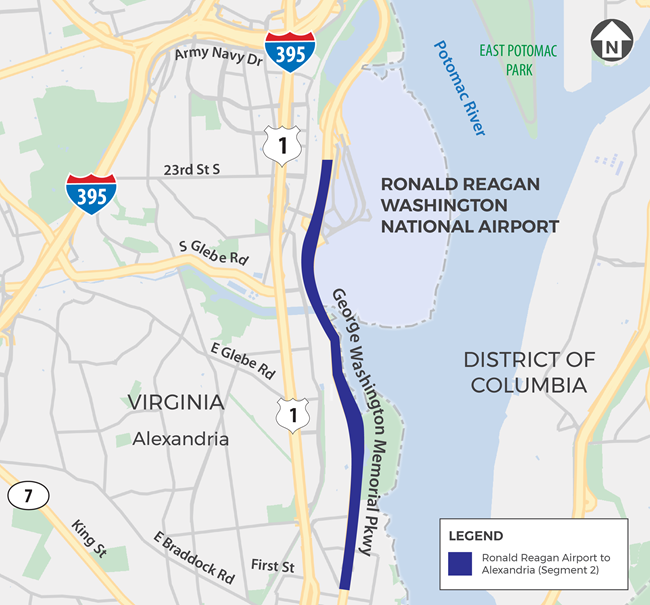

    Just south of the project limits from Spout Run Parkway south to I-395 and from Ronald Regan Airport to First Street in Alexandria, the George Washington Memorial Parkway will undergo mill and overlay work. This will rehabilitate the asphalt and extend the life of the roadway in this section of the parkway. This work is anticipated to start in spring 2026 once weather conditions are suitable for asphalt work.

The NPS understands the parkway's importance for motorists and is working efficiently to complete its rehabilitation to minimize prolonged congestion for this additional effort while ensuring safety for the public and construction crews. The NPS will provide additional information on the work and traffic impacts ahead of the construction.

Frequently Asked Questions (FAQs)

Aerial view of Route 123 and the proposed GWMP Interchange Option One. The curved sections in purple would be removed and the proposed configuration is in blue and is more linear. The Limits of Disturbance boundary is a dashed yellow line.
