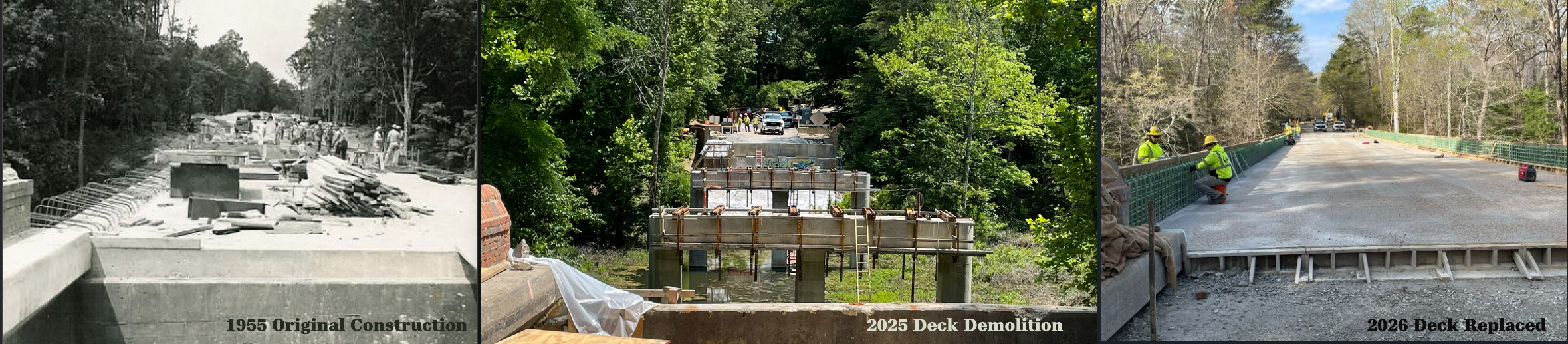

NPS Photo In 2023, the National Park Service (NPS), in partnership with the Federal Highway Administration (FHWA), launched a four-year, $123 million project to restore the historic Colonial Parkway. Funded by the Great American Outdoors Act (GAOA), this once-in-a-generation investment will restore and extend the life of approximately 10 miles of the Colonial Parkway. The work includes:
— all while preserving the aesthetic integrity and historic character that makes this road so unique. The Parkway Rehabilitation is in its final phase

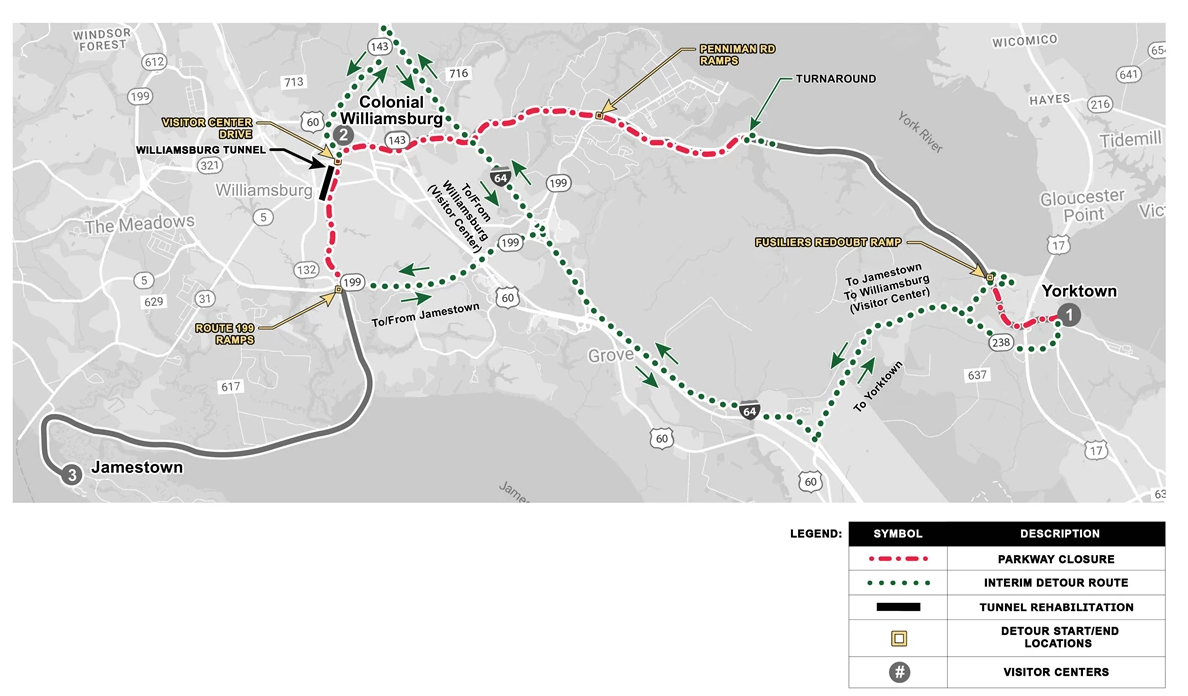

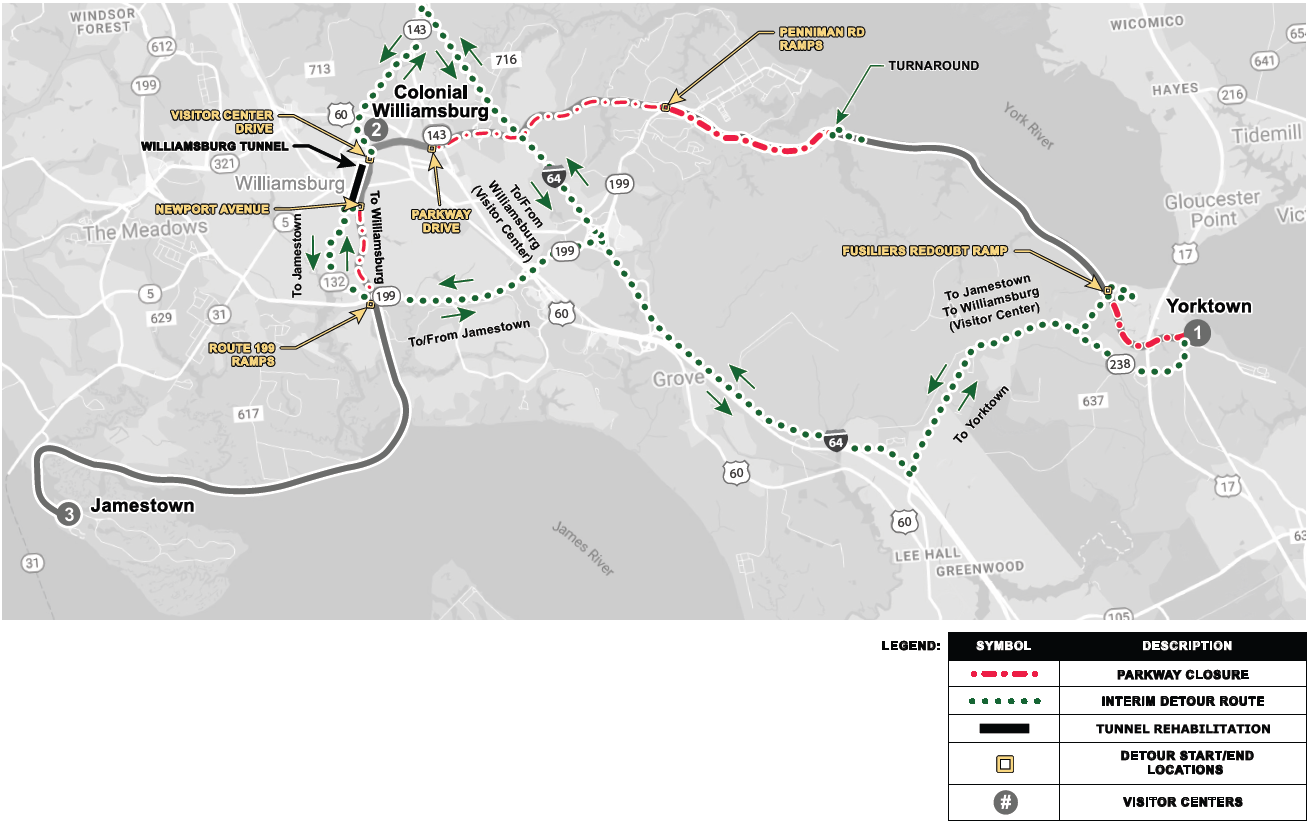

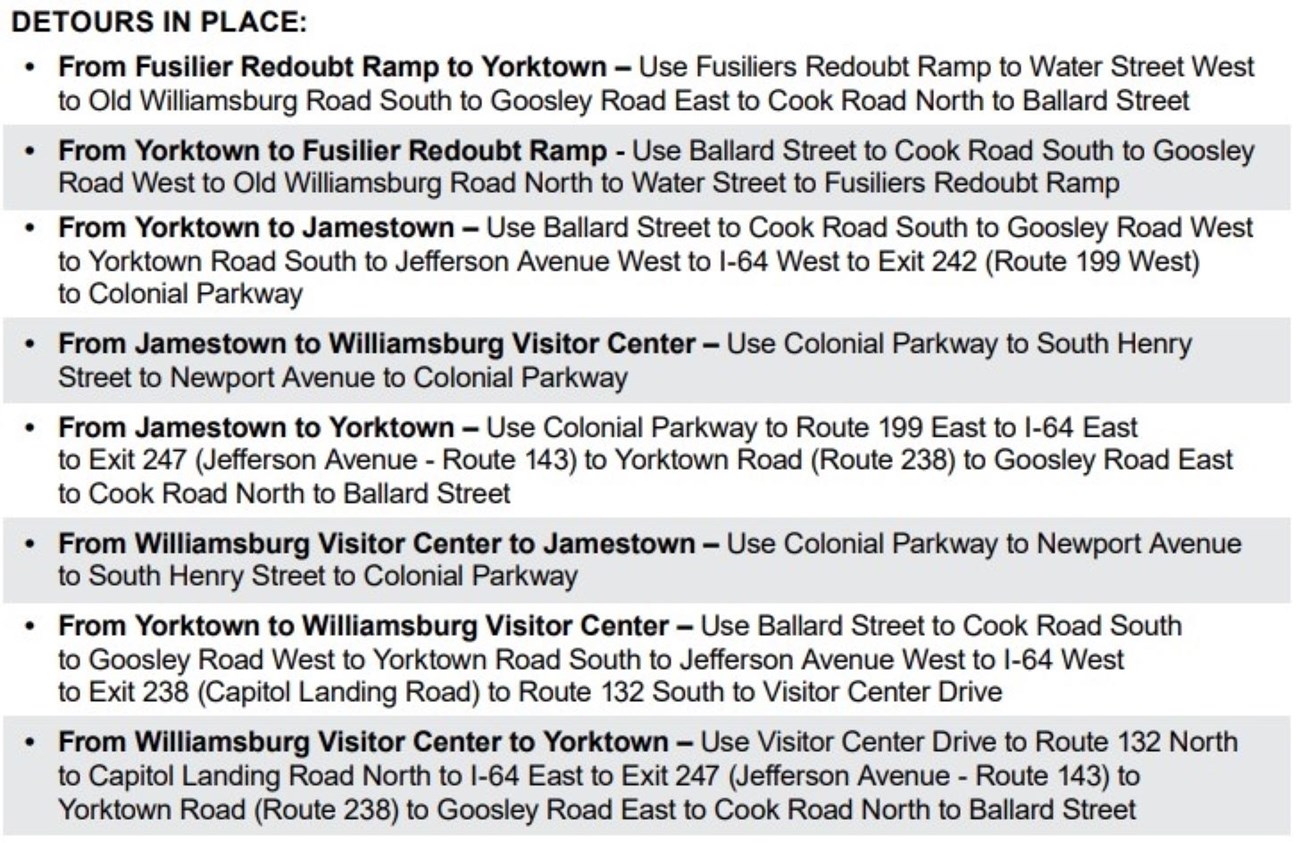

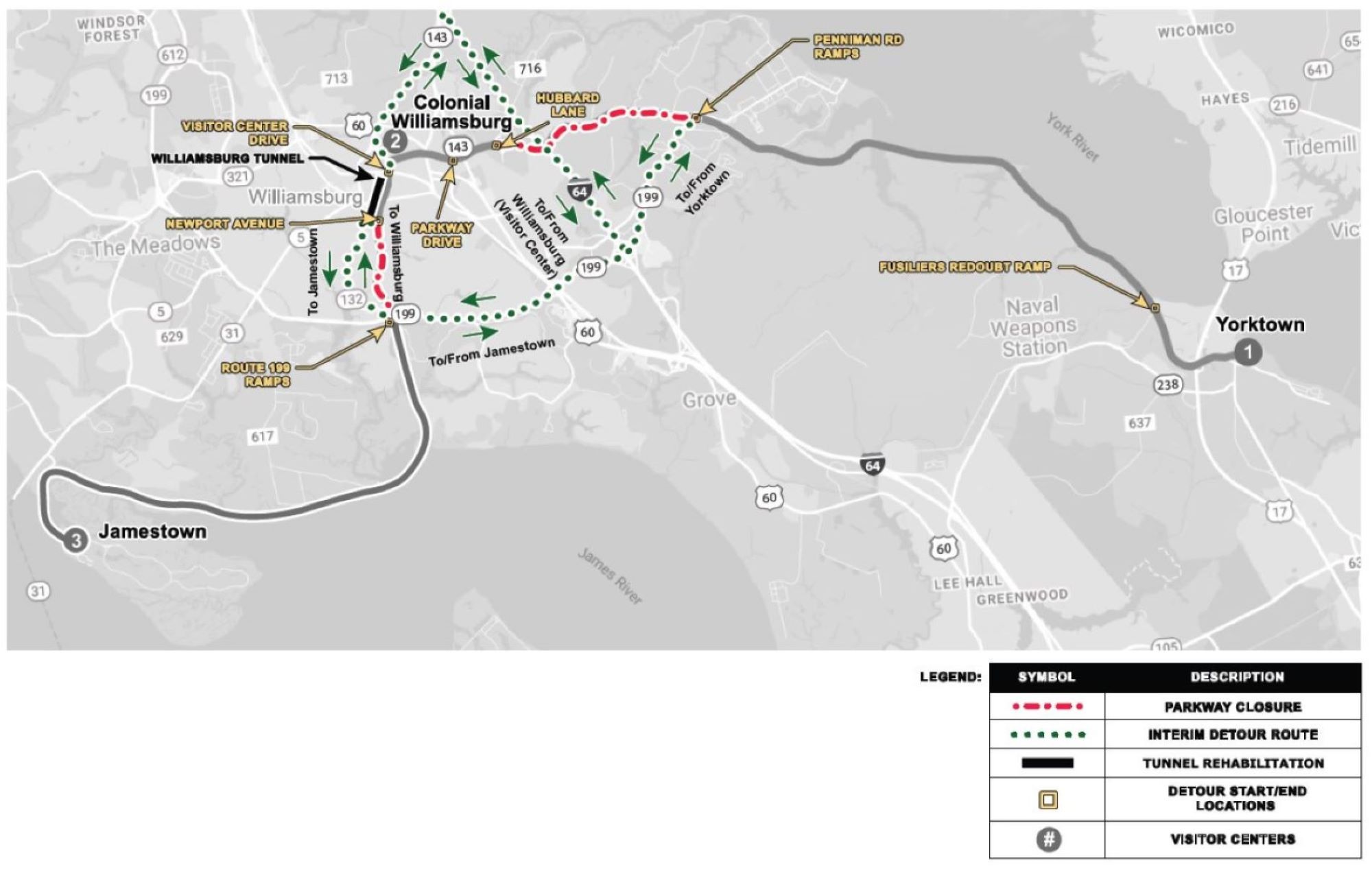

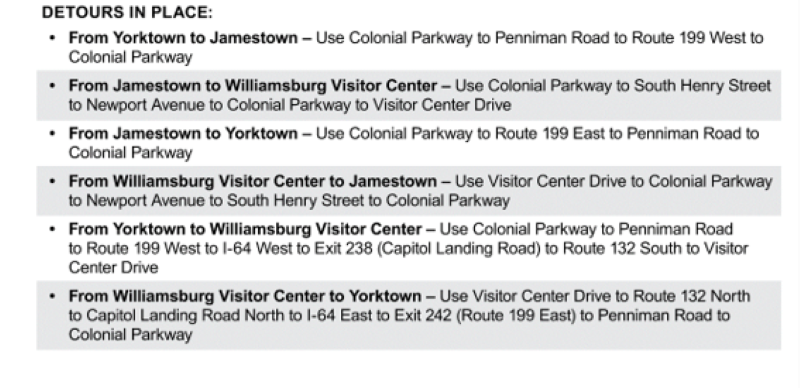

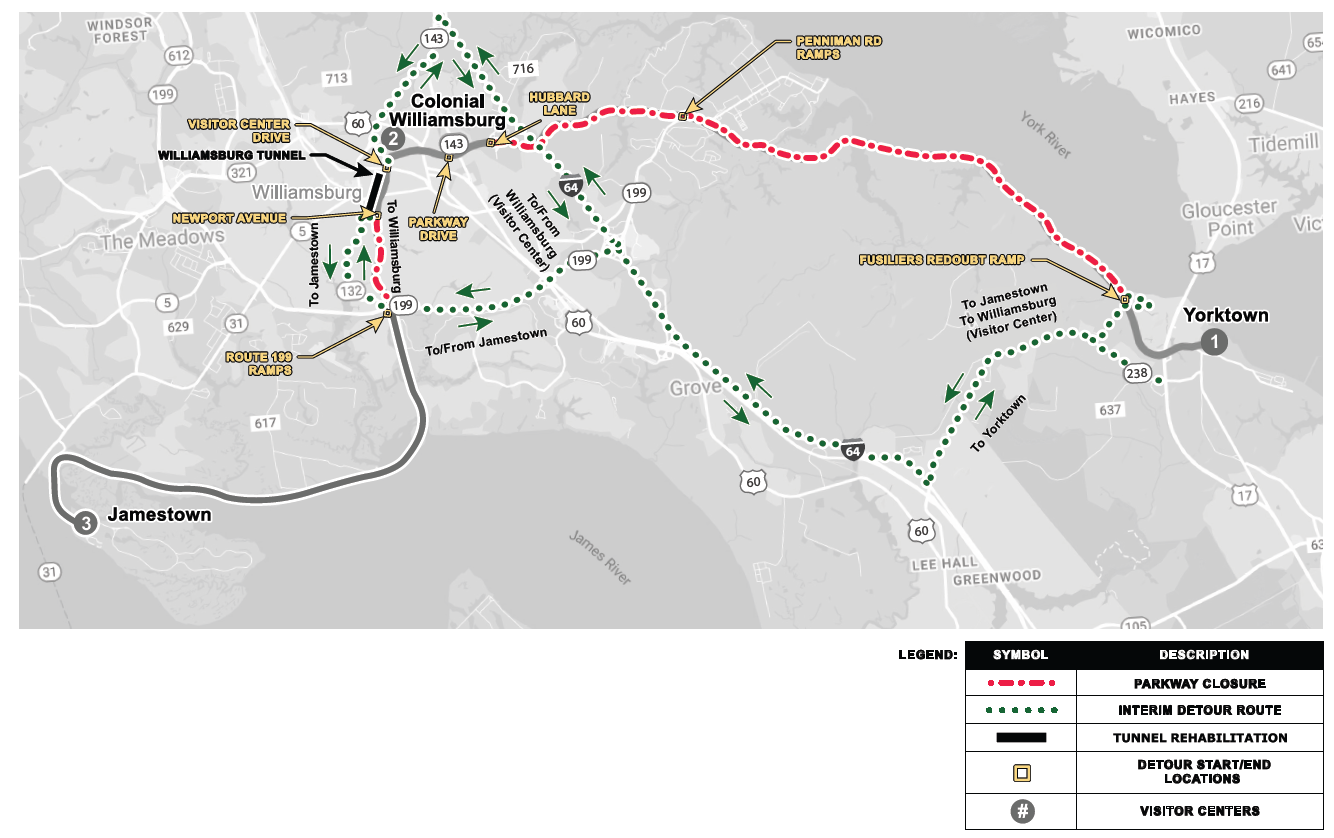

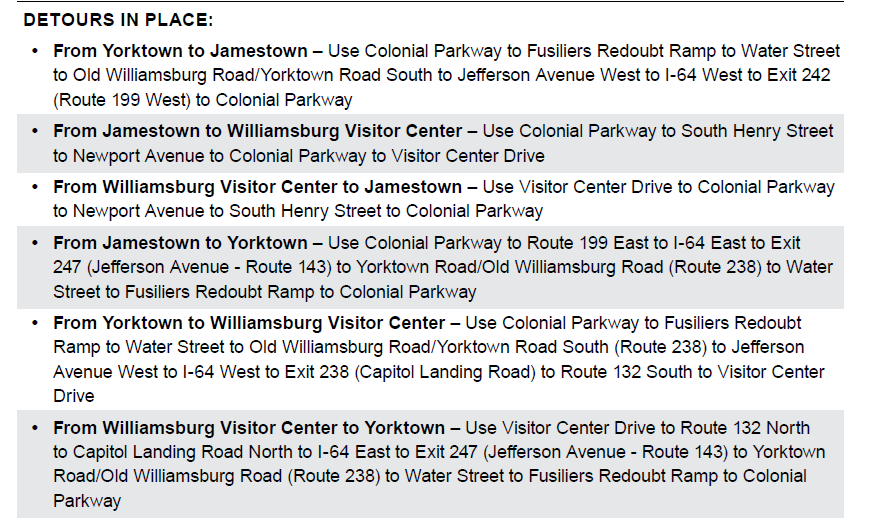

Current Detour MapThe following map shows the current detours and closures. We ask all travelers to follow all posted detour and caution signs and remain alert for workers, equipment, and changing traffic patterns. Your cooperation helps keep both crews and visitors safe while this important work is underway.
NPS Graphic

Current Project Timeline & Map

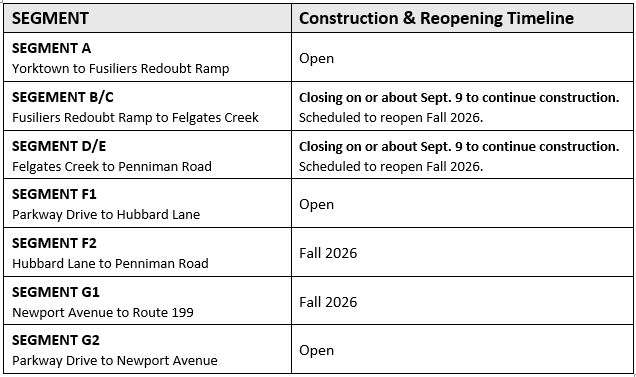

NPS Below is the anticipated timeline for segment openings and closures.

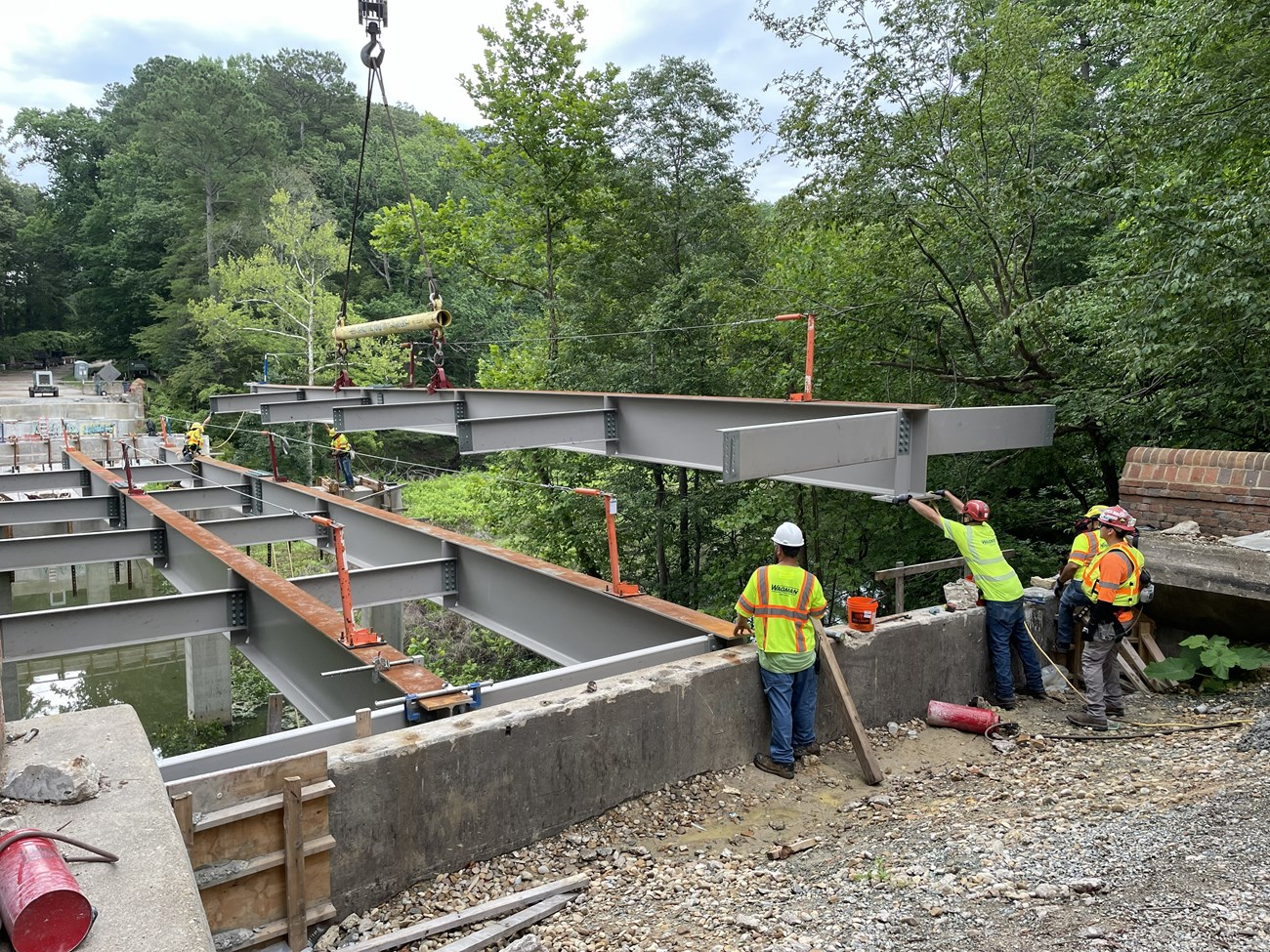

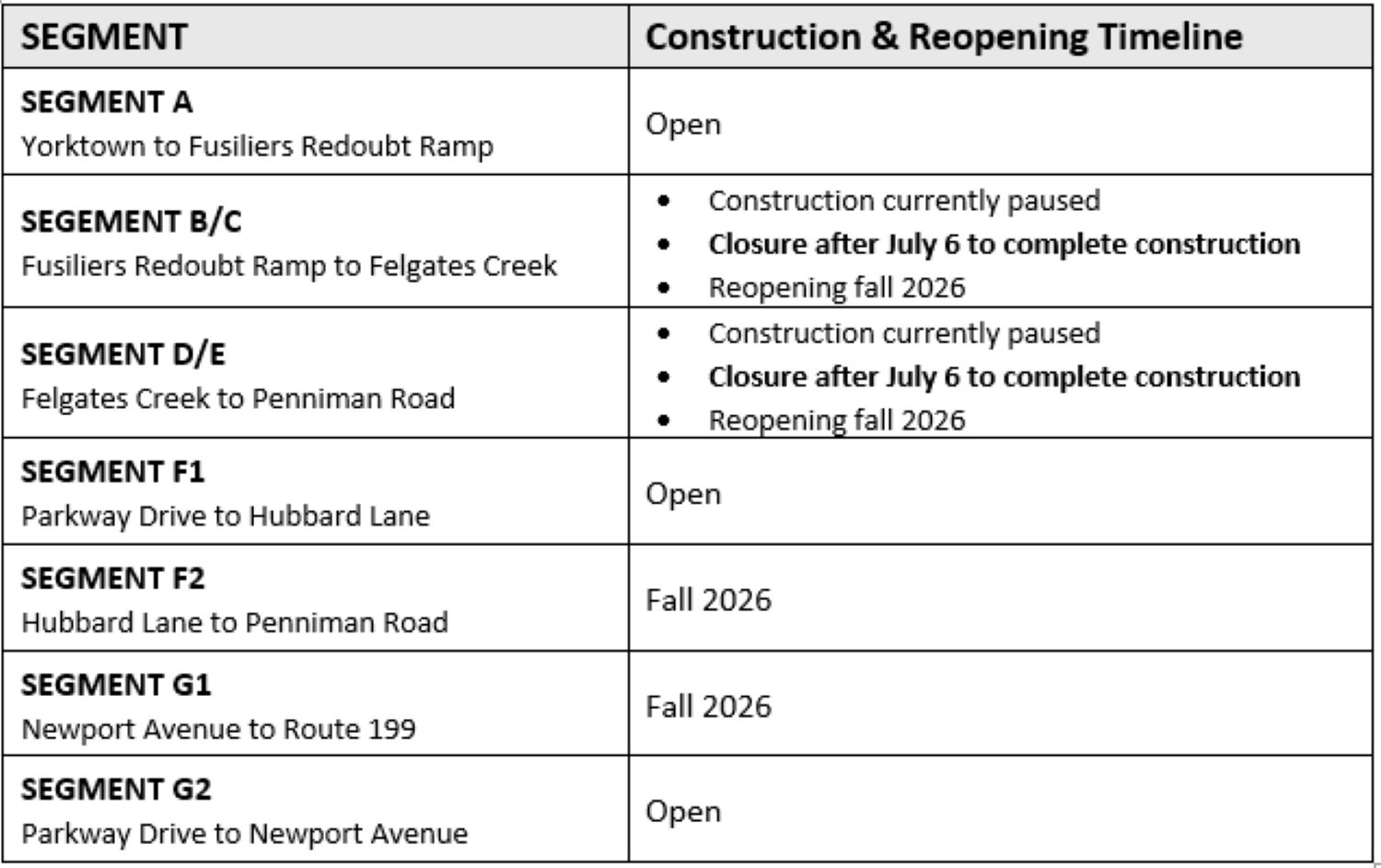

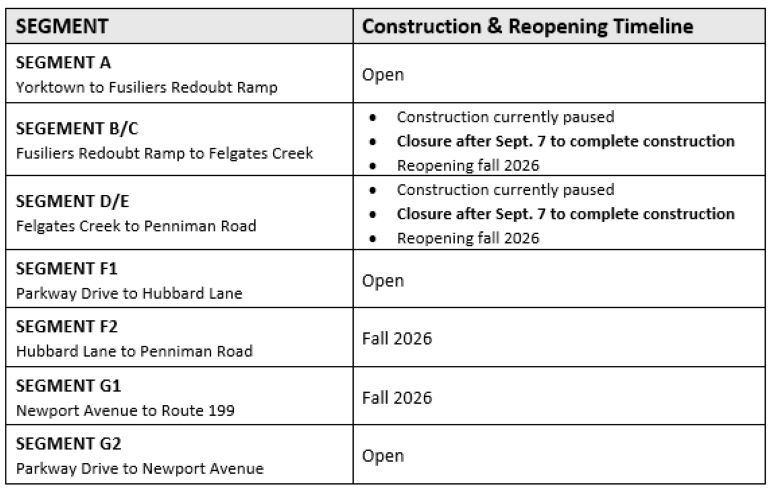

NPS Construction Update - July 2026We are excited to report crews have made substantial progress across the project.
We remain on schedule to complete the full project by fall of 2026. Below is the latest status of each segment:
Below is the latest status of the additional projects within the Parkway Project Corridor:
Project FAQSWhat is the Colonial Parkway Rehabilitation Project?The Colonial Parkway Rehabilitation Project is a once‑in‑a‑generation investment to restore and extend the life of approximately 10 miles of the Colonial Parkway. Much of the Parkway’s infrastructure is approaching 90 years old, and comprehensive rehabilitation is needed to address aging systems, improve safety, and preserve its historic character.
— all while preserving the aesthetic integrity and historic character that makes this road so unique.
The result will be a safer, smoother, and more scenic experience for the next 40–50 years. How was the project funded?This work is funded by the Great American Outdoors Act (GAOA) Legacy Restoration Fund — a bipartisan initiative designed to tackle long-standing maintenance needs in national parks. Who is doing the work?This project is managed by the Federal Highways Administration (FHWA) in partnership with the National Park Service (NPS) through a design-build team that includes a prime contractor, design specialists, and approximately 30 subcontractors. When will the Colonial Parkway fully reopen?The Colonial Parkway is expected to fully reopen by fall 2026, once all remaining infrastructure and preservation work is completed. Some segments may reopen earlier if they meet required safety and quality standards. What work still needs to be completed on the Colonial Parkway?The park was awarded additional GAOA and Federal Lands Transportation Program funding to address other major infrastructure and deferred maintenance projects within the Parkway corridor. Additional time is also needed to ensure that the workmanship maintains the aesthetic craftsmanship and historic character the Colonial Parkway is known for.

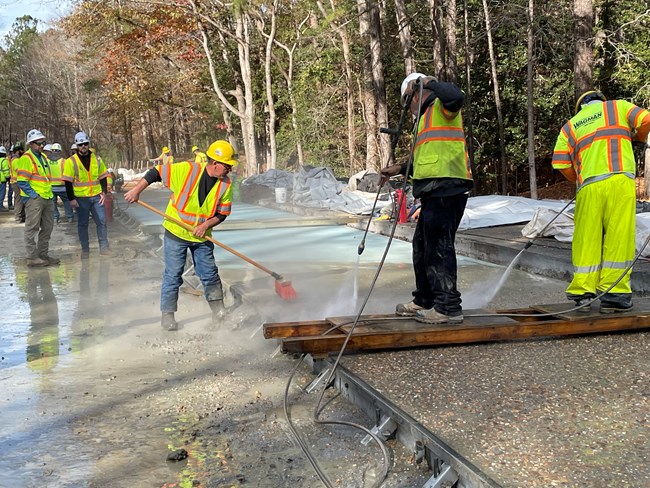

Completing these projects together reduces the need for future closures and helps preserve the Parkway’s historic character for generations to come. Why is maintaining the Colonial Parkway’s historic character so important?The Colonial Parkway is more than a road—it’s a living piece of American history and a cultural treasure. Listed on the National Register of Historic Places, designated an All-American Road, and celebrated as “one of the finest parkway archetypes in the country,” it offers visitors a one-of-a-kind experience. How will the project preserve the Parkway’s historic look and feel?Maintaining the Colonial Parkway’s iconic aesthetic is a top priority. The project carefully replicates its historic exposed-aggregate concrete roadway, restores brick bridges and culverts, and safeguards the cultural landscape that makes this scenic route so unique. All improvements are designed to enhance longevity without compromising the Parkway’s character and timeless beauty. What steps are involved in creating an authentic, historically accurate aggregate surface?Exposed aggregate paving is a longer, more labor-intensive process than traditional blacktop repaving. This project requires full-depth roadway reconstruction, including subgrade rehabilitation and installation of the final exposed aggregate driving surface. Which areas are currently closed, and what detours should I use?All segments within the project limits are currently closed to traffic. Please follow posted detours and check the project webpage for the most up-to-date maps and reopening information. What determines whether a segment can reopen?Before reopening, each section must pass safety inspections and meet quality standards for aesthetic quality, historic character, pavement, drainage, bridges, and tunnel systems. |
Last updated: June 30, 2026
